Brunel Swivel Bridge Project Photos January 2015
![]() Swivel Bridge Leaflet available in the Central Library Exhibition and from the website. Leaflet gives information, asks for support and how to make a donation |
Page contents
Work PHASE B Preparation and Basic Conservation by Volunteers
- Removing some patch-repair plates to allow us to clean & inspect the inside of enclosed sections. We have agreed to carry out a permanent repair now as follows to the investigative test section. This will be done by Dorothea Restorations
- Erecting a simple timber roof
- renewal of the timber stop.
- Moving the timber and erecting our new interpretation panels
- More Cleaning and painting rusty areas
- Unbolt and release the centre pintle casting
- Jack up Bridge further
- Level and Dimensional Survey
- Metalwork condition survey using Ultrasonic equipment from DMV
- Kentledge Weight Survey
- Paint Analysis
- Site Investigation, Excavating a hole adjacent the CI bed, SE side to search for a timber foundation-beam
- Locate and obtain copies of drawings and past reports. Write a conservation plan
- Seek letters of support
Details of progress in 2015 and working days.
January 2015
Library Exhibition 5 January to 15 Feb![]() Marilyn and her husband and Mike Taylor pondering how to display boards |

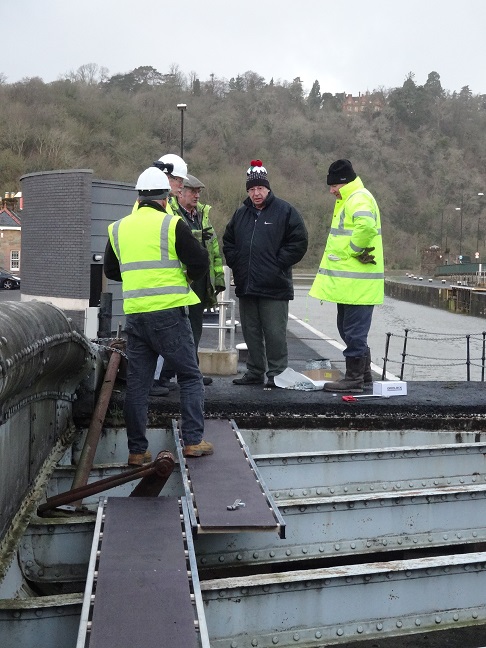

![]() Lots of boards |
![]() sponsor boards and our new leaflets on display |
![]() Marilyn Adams of AIBT who organised the exhibition looking relieved and happy |

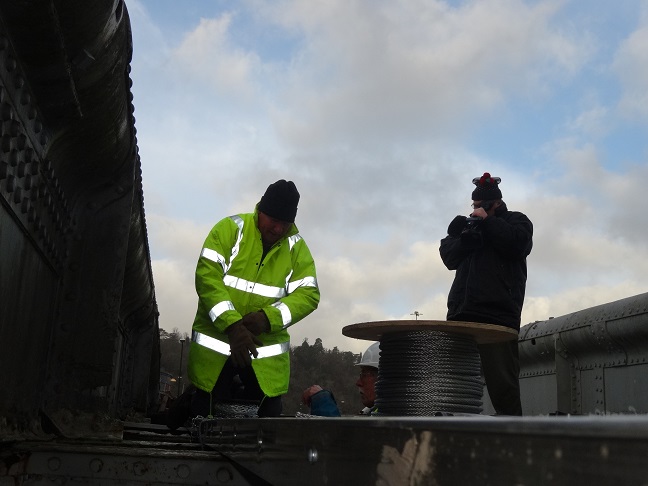

![]() Julian from BFVS discusing how to film the project |
![]() Geoff, Martyn, Bob and Mike securing our new boards |
![]() Julian filming Bob |
![]() Julian filming Geoff |

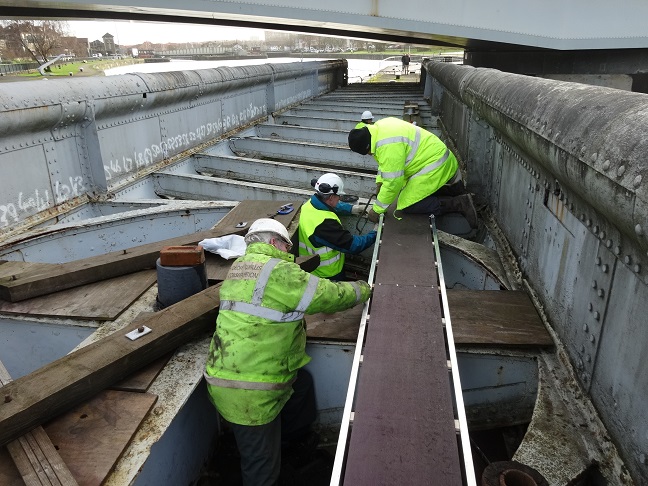

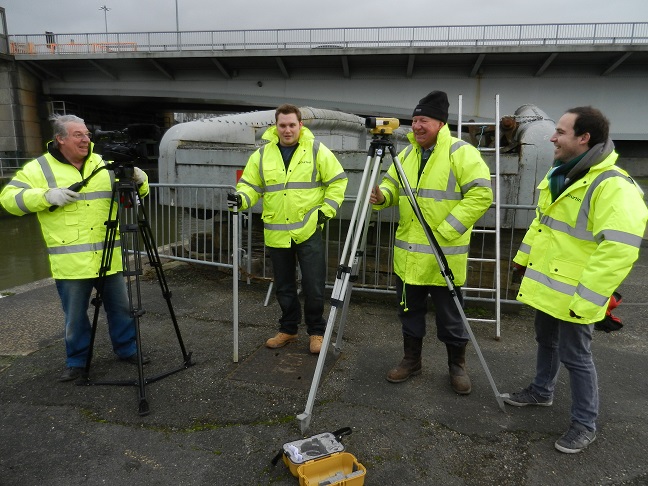

![]() Julian, John, Bob and Tom doing the first survey of the year |

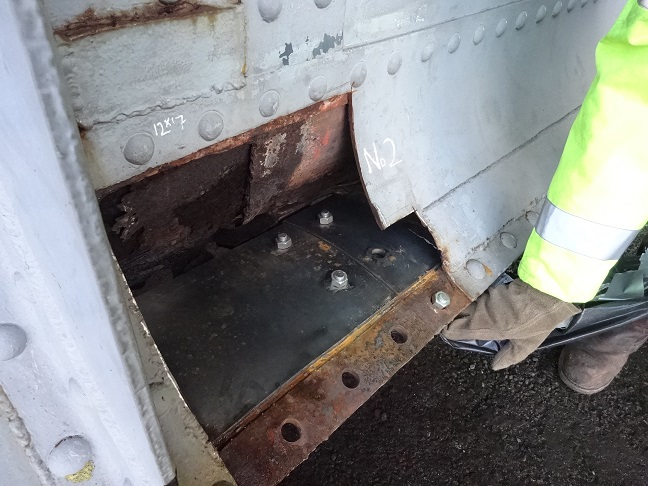

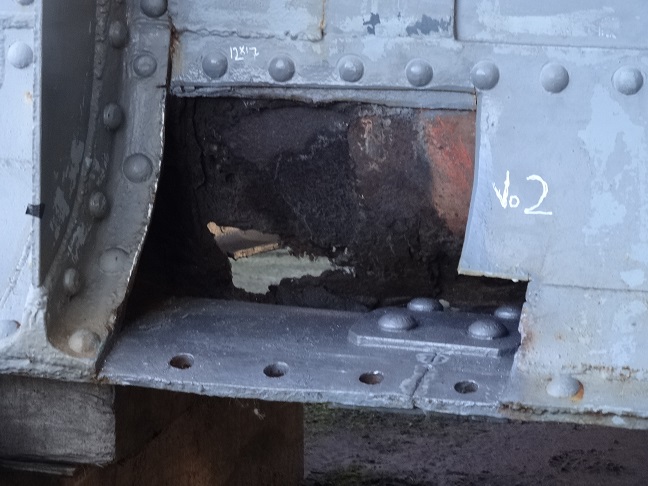

![]() Sample Repair Plates |

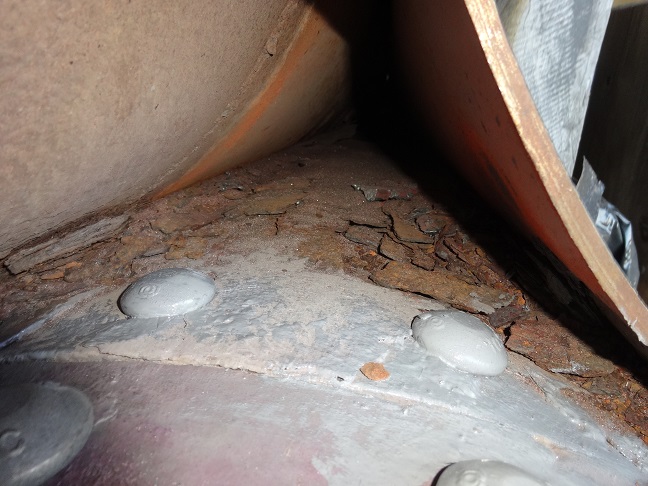

![]() Inside the tear section |

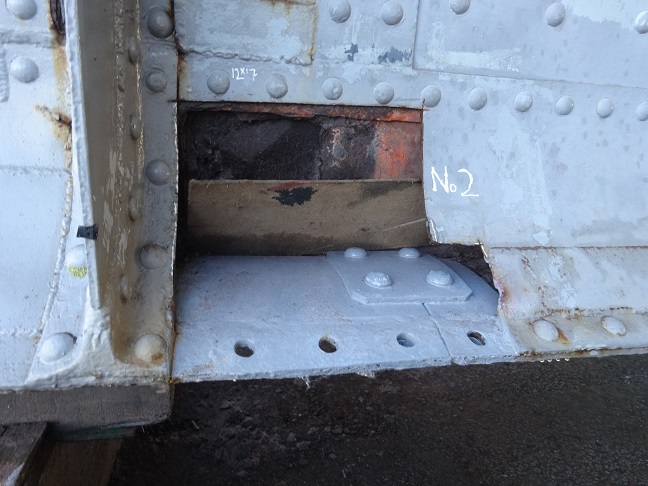

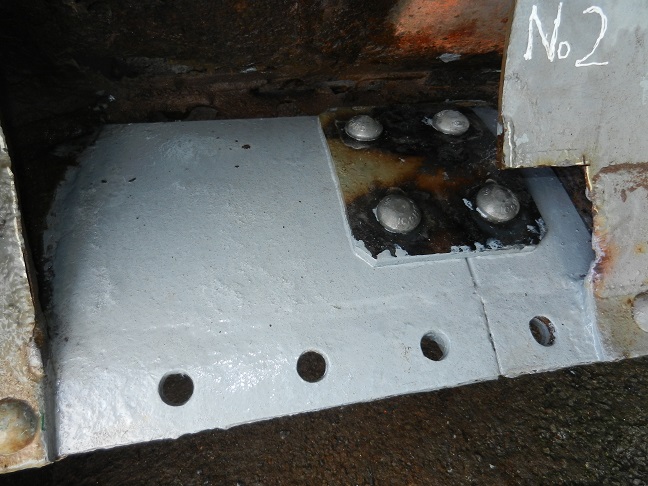

![]() repair-plates going in on the bottom triangular section of the south side-beam |

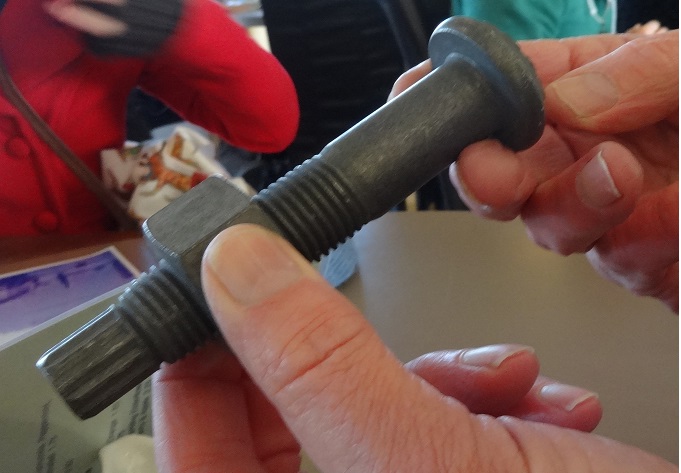

![]() The four bolts are special high-strength friction-grip bolts put in with a special pneumatic gun that tightens them by means of a spigot on the end that breaks off when the bolt is tight enough. They are very effective, and we are considering using them where we can't get in to rivet. | ![]() high-strength friction bolt |

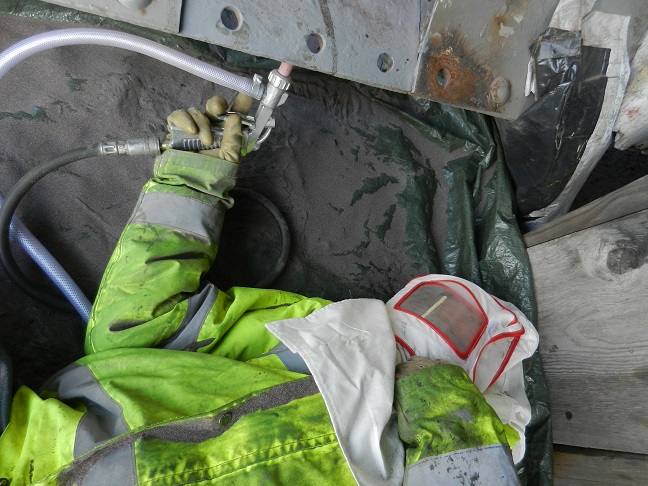

![]() One of Dorothea's staff in protective gear laying next to the Bridge spot-blasting the underside prior to painting using a hard grit called aluminium oxide which scours away the rust but not the wrought iron. |

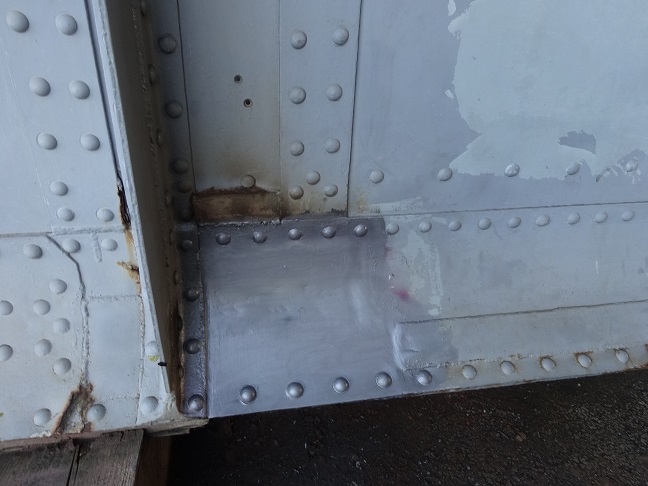

![]() finished repair |

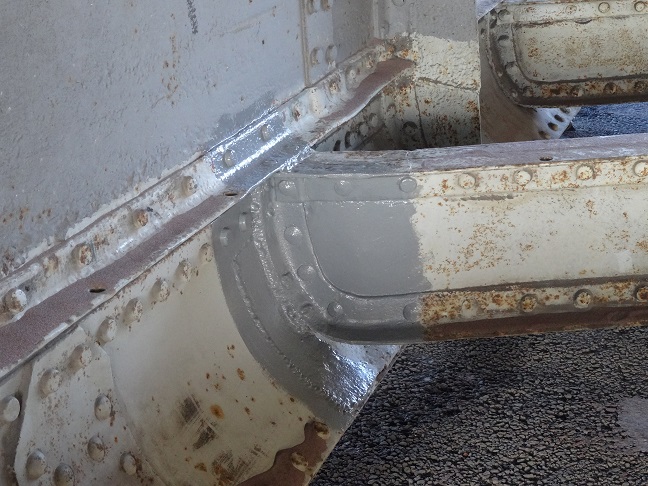

![]() Another sample area blast-cleaned and painted |
![]() Geoff and Mike with Sarah- Underfall Yard's new Community, Learning and Volunteers Manager |
![]() Geoff and Mike got Sarah down into the wheel pit |

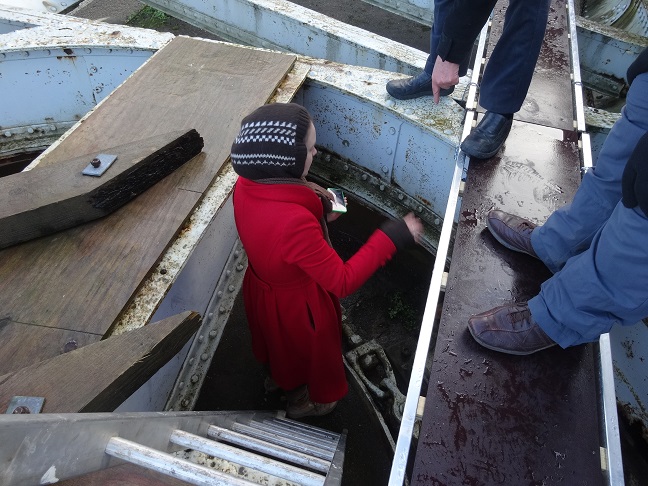

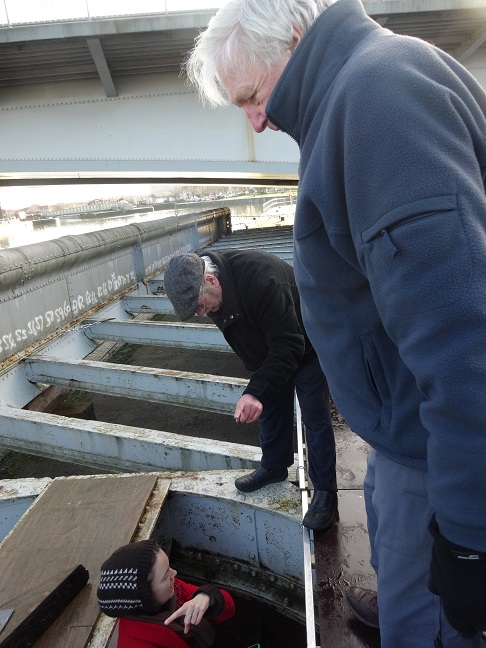

![]() Sarah having a look for herself |
![]() Geoff gave Sarah a quick powerpoint presentation and showed her how the friction-grip bolts work |
Monday 19 January: Hot rivetting day!

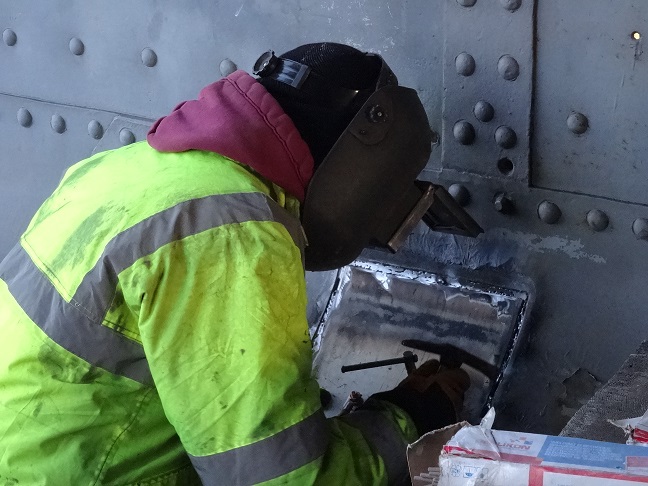

![]() First one makes sure the inside section is clean and painted. The curved piece on the other side is so rotten at this point it will have to be replaced |

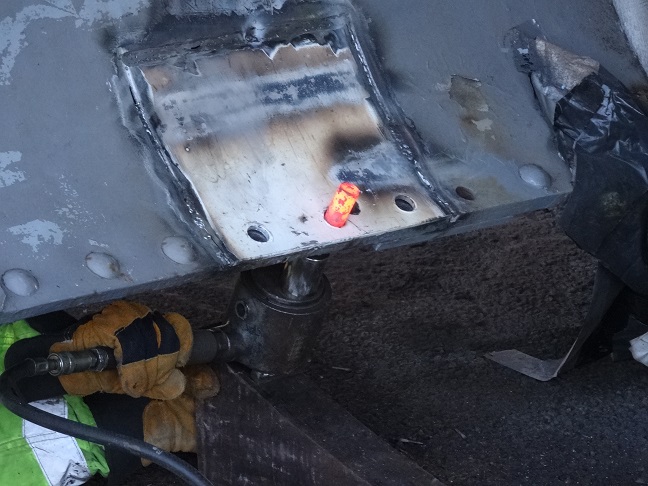

![]() One welds the curved replacement patch in position. Rivet Holes lined up and checked |

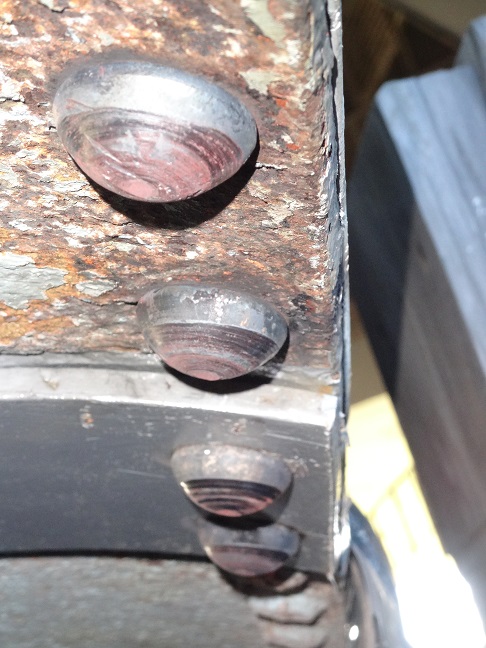

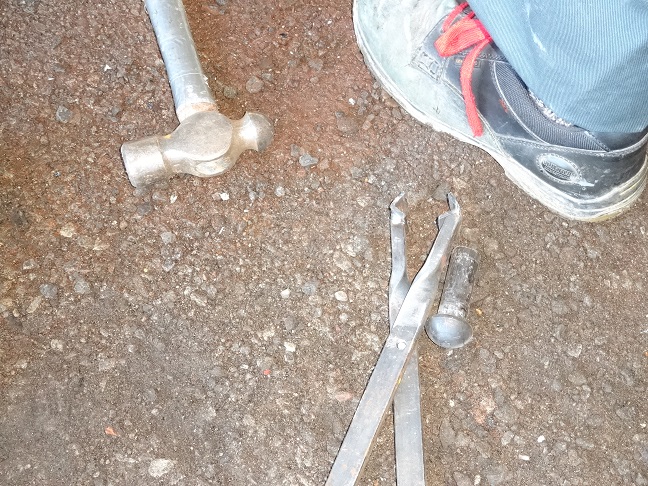

![]() One gets the tongs and rivets- which must be the correct size since both ends will end up rounded and must hold the plates tightly together |

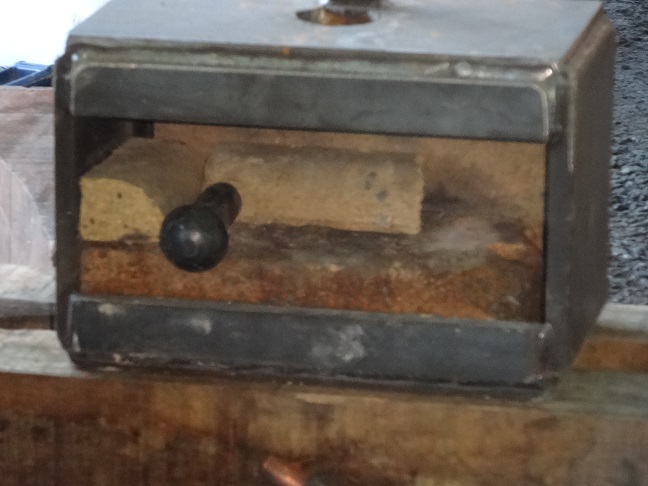

![]() One makes a little oven to heat the rivets in |

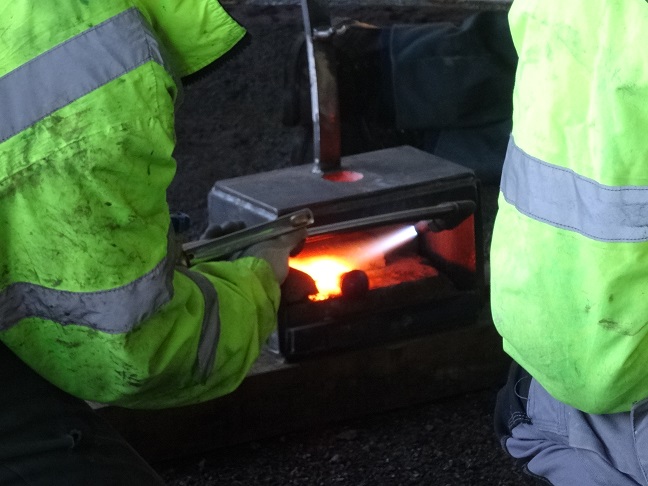

![]() Heats up with the gas torch |

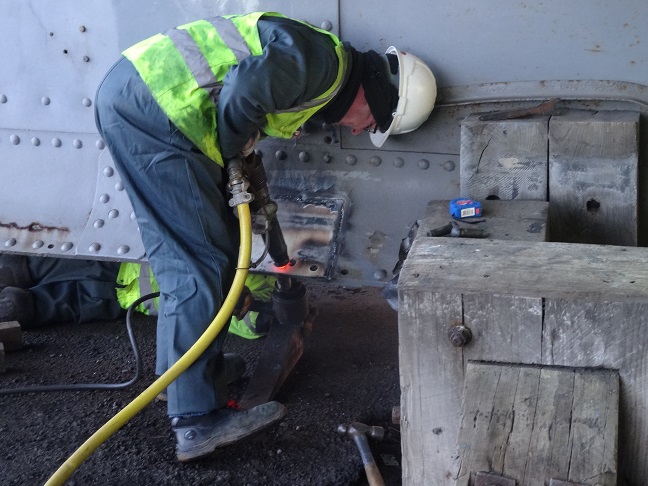

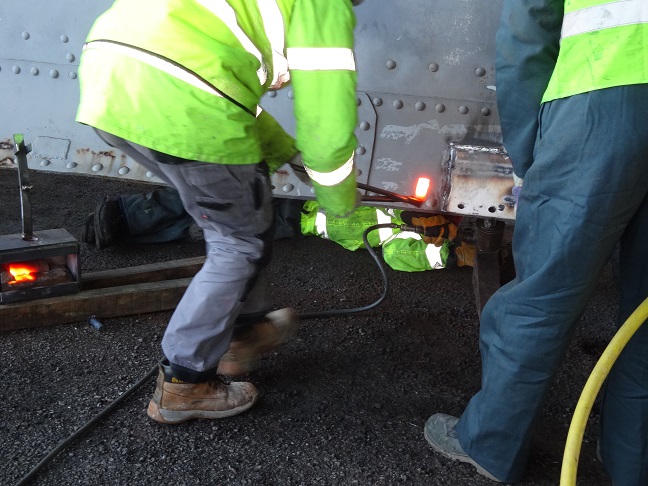

![]() Runs over to the bridge with hot rivet |
![]() Puts it in the hole ready for the pneumatic hammer to hold the head |
![]() A 'holder-up' or 'backer-up' is used on the tail of the rivet. The energy from the hammer drives the work and the rivet against the inertia of the backer up. As a result, the tail of the rivet is rounded. The rivet does not harden on cooling, or it would be brittle. It does though contract and pull the plates tight which makes a really tight joint, hopefully water-tight (which is why it must be the right size and allow for the rounding). |

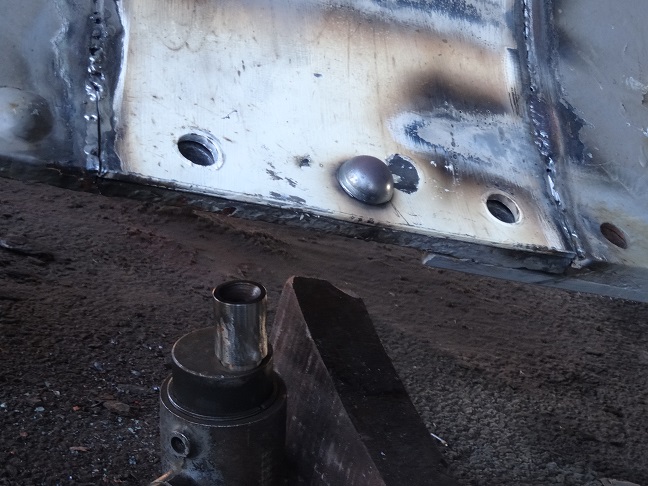

![]() Looks good |
![]() All done, bar tidying up the joins and painting |

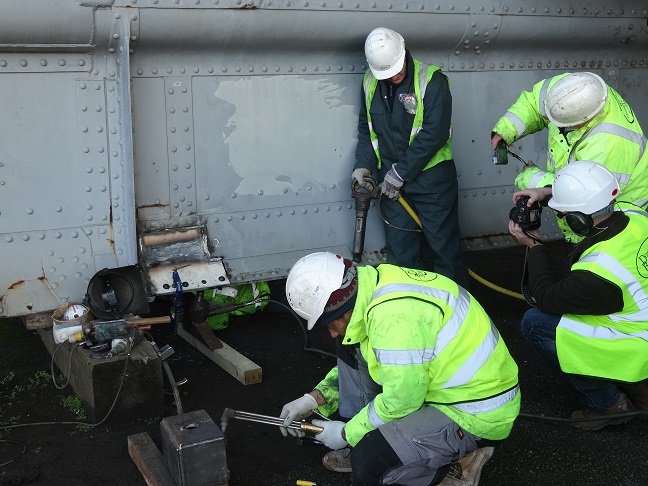

![]() Its not every day one sees hot rivetting on the side of the docks so lots of photos. Julian Baldwin was there filming too |
![]() Completed job |
